Abstract natively uses the ZKsync VM to execute smart contract instructions, however an EVM bytecode interpreter system is also available to enable the deployment of unmodified EVM bytecode, commonly referred to as “EVM equivalent” smart contracts. This enables smart contracts that rely on EVM logic (such as consistent address derivation) to be deployed on Abstract without modification. However, this approach is not recommended for most use cases due to comparatively higher gas fees.Documentation Index
Fetch the complete documentation index at: https://docs.abs.xyz/llms.txt
Use this file to discover all available pages before exploring further.
How It Works

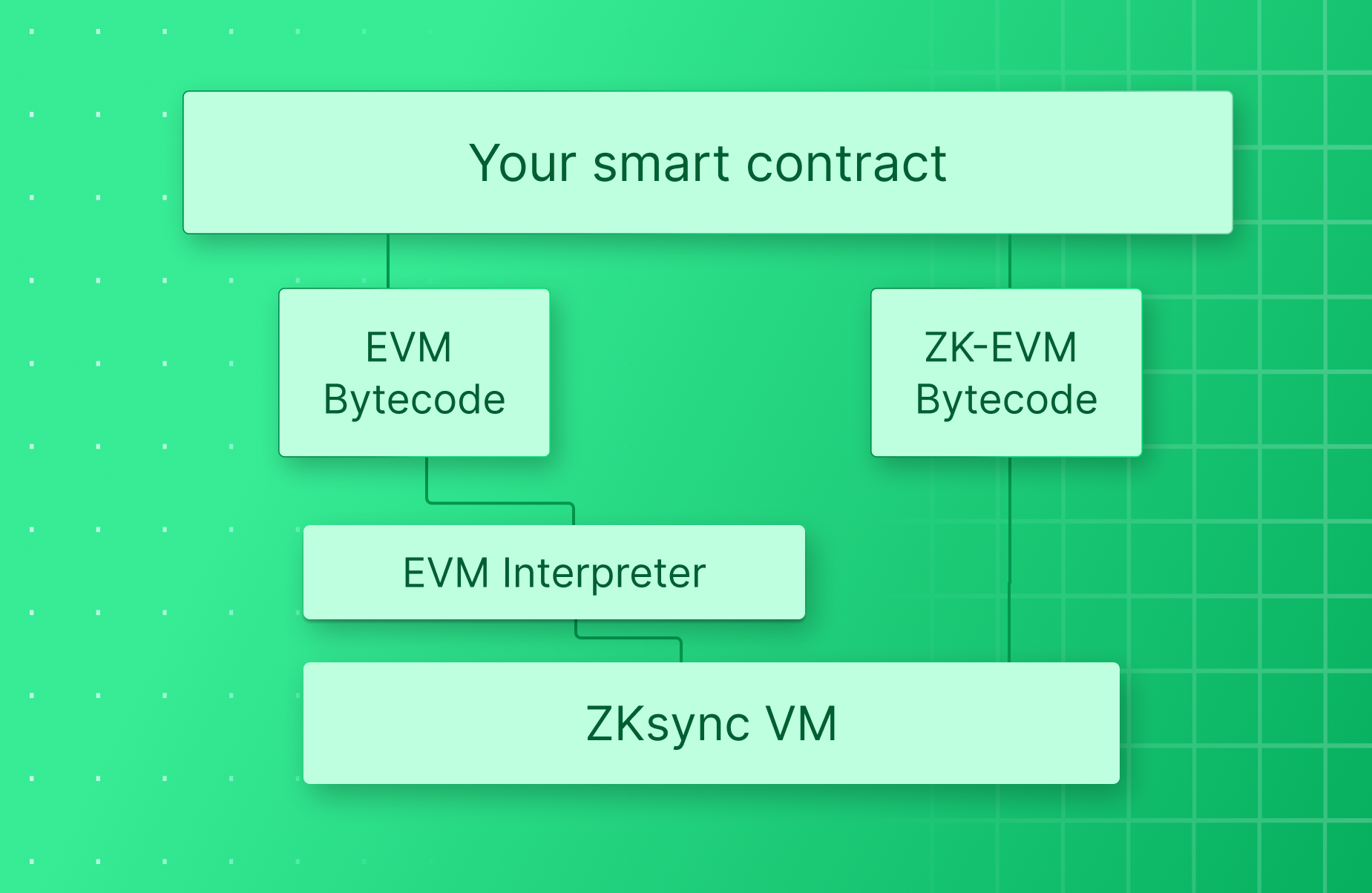

There are two ways to deploy smart contracts on Abstract:- ZKsync VM Bytecode: Compile contracts into ZK-EVM bytecode using ZK specific tooling and deploy to Abstract. These contracts are executed natively by Abstract’s ZKsync VM.
- Recommended for most use cases.
- EVM Bytecode: Compile contracts into EVM bytecode using existing EVM tooling and deploy to Abstract.
- Contracts deployed this way are flagged as EVM bytecode and are executed via the EVM interpreter. During execution, the contract’s EVM opcodes are translated into the ZKsync VM’s instruction set and executed by the ZKsync VM.
- Gas fees are 150-400% higher than contracts deployed using native ZKsync VM bytecode due to the translation process.
- Recommended only for use cases that require specific EVM features not supported by the ZKsync VM (see EVM differences).

Opcode Translation & Gas Fees
The EVM interpreter functions as a translation layer that converts EVM opcodes into ZKsync VM operations at runtime as part of the smart contract execution process. As a consequence of this translation process, contracts deployed with EVM bytecode experience increased gas fees of between 150-400% compared to contracts deployed using the native ZKsync VM bytecode.Execution Flow
The code hash of smart contracts are stored in the AccountCodeStorage system contract, and upon deployment, are pre-fixed with either:0x01: Flag for Native ZKsync VM bytecode.0x02: Flag for EVM bytecode (i.e. EVM equivalent smart contracts).
Check code hash prefix
To determine the type of bytecode that this contract was deployed with,
first, a check is made to see if it is prefixed with
0x01 or 0x02.Translate & execute opcodes
If the contract is native ZKsync VM bytecode (prefix
0x01), this step is skipped.Otherwise, the EVM interpreter interprets and executes opcodes in a loop; translating EVM opcodes into ZKsync VM instructions;
execution continues until completion, error, or out-of-ergs condition.Limitations
DELEGATECALLbetween EVM and native ZKsync VM contracts will be reverted.- Calls to empty addresses in kernel space (address < 2^16) will fail.
GASLIMITopcode returns the same fixed constant as ZKsync VM and should not be used.
CALLCODESELFDESTRUCTBLOBHASHBLOBBASEFEE
